Hayhurst Neighborhood Association

Category: Alpenrose site

  • Raleigh Crest / Alpenrose site updates

    Raleigh Crest / Alpenrose site updates

    Drive down Shattuck Road, and you’ll see the landscape changing at the old Alpenrose Dairy site, almost by the hour. Gone are all of the dairy buildings, and the open fields are dotted with mounds of dirt and heavy equipment. Over the last month, excavators and graders have been leveling out roadways, and diggers have been carving trenches for sewer and utility lines for the new Raleigh Crest development.

    At the monthly “Good Neighbor” meeting on June 3, development managers from AKS Engineering reported on the construction schedule updates for this summer:

    Utilities and curbs

    Stormwater and utility conduits will be installed on SW Shattuck Road the week of June 8. Traffic control will run along Shattuck and will be needed at times near SW Pendleton Court during that week.

    The stormwater connection across SW Dover Street will be installed between June 18 and 26.

    Construction of onsite curbs will also begin in June.

    The City of Portland will be connecting the water main at SW Illinois, which will require a road closure.This should be a one-day project—the exact date is not yet known.

    Home construction is expected to begin in early fall.

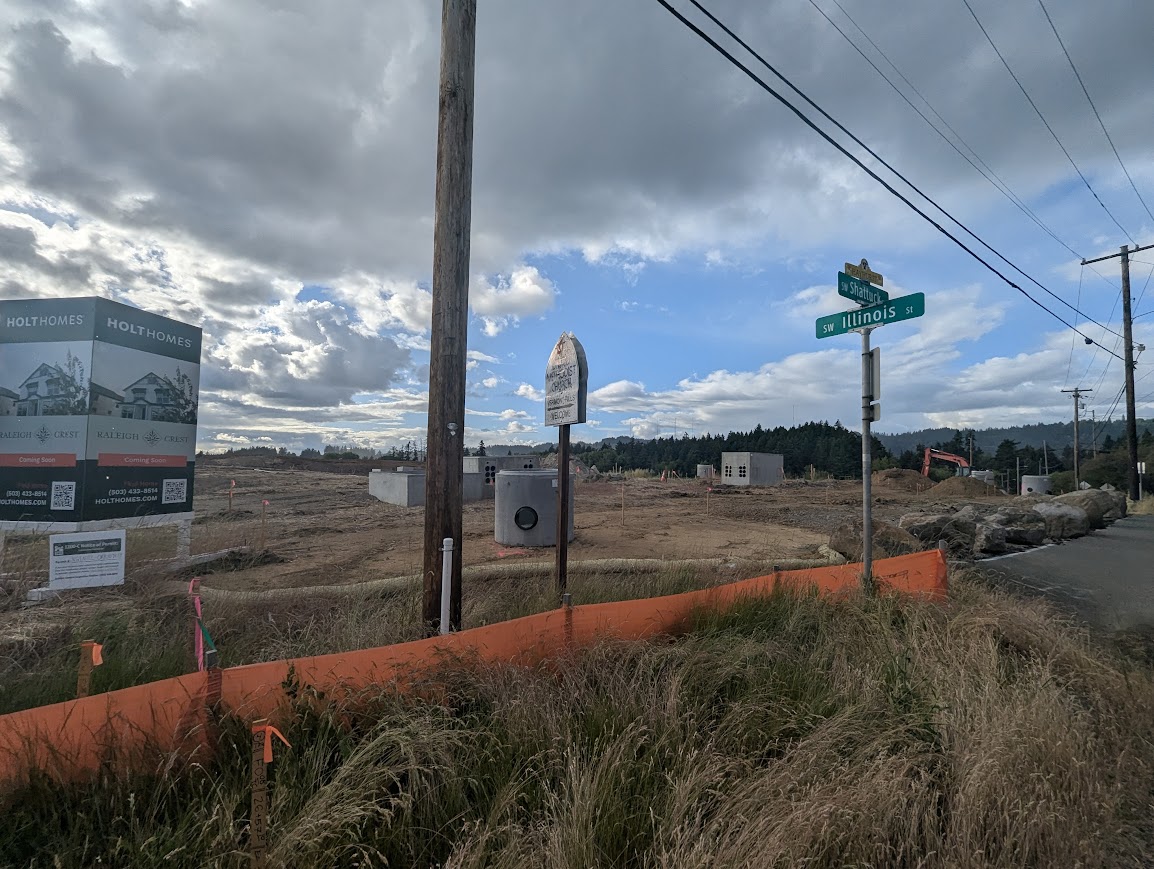

    Raleigh Crest construction on the old Alpenrose Dairy site, SW Shattuck Road at SW Illinois St.

    View of the Raleigh Crest Site from the corner of SW Illinois and SW Shattuck June 8, 2026

    Construction vehicles at SW 60th near Shattuck Road, near Raleigh Crest development at the Alpenrose Dairy site
    credit: Beth Blenz-Clucas

    Red ElectricTrail and Shattuck pathway

    The foundation is in place for the new Red Electric Trail. The Holt Homes landscaping team will design the transition from Shattuck to the trail.

    The multi-use pathway along Shattuck will no longer have the two-foot landscape buffer between the walkway and bikeway due to future maintenance needs. The current plan is to create a wider buffer of street trees and water catchment planted with the City of Portland’s choice of native plants between Shattuck traffic lanes and the path.

    Shattuck Road speed cushions

    Meanwhile, Hayhurst Neighborhood Association is still advocating with the City of Portland to install speed cushions along SW Shattuck Road. Board members are communicating with Portland Fire Chief Lauren Johnson, who expressed reservations about adding the bumps, due to Shattuck’s status as a Major Emergency Response Route. Chief Johnson stated, “Installing speed cushions on a Major Emergency Response Route that only has one lane each way, no improved shoulders, and no room for cars to pull off onto a shoulder can really slow Fire responses.This area of Portland already experiences longer response times and I am concerned about additional delays.” The city’s transportation bureau will continue to look for ways to make the street and intersections safer for pedestrians and bicyclists, and they are making plans for crosswalk striping and sidewalks at the intersection of Shattuck and SW Illinois. Read the Fire Chief’s letter to Hayhurst N.A. here.

    But, as Hayhurst Neighborhood Association Board member Alissa Cattone noted in a response to the Chief, “These updates don’t appear to go far enough, particularly to keep children safe. We are very concerned about the currently perilous conditions on SW Shattuck Road, and at the SW 60th/Illinois/Shattuck intersection in the Hayhurst neighborhood that aren’t adequately being addressed.” Cattone and other neighbors point to the existing Shattuck Road speed cushions to the north of Hayhurst in the Bridlemile neighborhood between Beaverton-Hillsdale Highway and SW Patton Road, which were constructed with gaps to ease emergency vehicle travel.


    Here is the current intersection crosswalk plan at SW Shattuck and Illinois/ 60th:

    Map of crosswoalk ar SW Shattuck Road at SW Illinois Street.
    Source: Portland Bureau of Transportation 2026

    Note: Hayhurst eighborhood Assoctiation holds a reserve fund to conduct a traffic study of the area surrounding Raleigh Crest development. The study will be done once Phase 1 of the development is occupied and a real-time assessment of actual increased traffic is possible. Neighbors are invited to participate in discussions about SW transportation issues at the monthly Hayhurst N.A. meetings.

    Submit your thoughts about the SW Shattuck Road traffic developments to Marita Ingalsbe, Hayhurst N.A. Chair, at hayhurstna@gmail.com

  • Raleigh Crest – Alpenrose Site Update February 2026

    Raleigh Crest – Alpenrose Site Update February 2026

    Neighbors met on February 4, 2026 for the monthly update with the Raleigh Crest Construction Manager (AKS Engineering) and Holt Homes. This month they are completing the sewer pipe installation, followed by the stormwater pipe installation and then water. The City of Portland approved public works plan is now at 90 percent.

    The fourth quarter 2025 wildlife camera footage was just completed and sent to the Bureau of Environmental Services. There will be another series of camera deployments after construction of the retaining wall on SW Shattuck Road. Neighbors requested an eDNA water sampling in Vermont Creek early this Spring, but that was denied by the developer due to safety and insurance concerns. The easements for Bureau of Environmental Services access cannot be recorded until all of the utilities are set in place.

    There are no renderings for the home designs yet, and no price points have been established. The home pictured on the sign on the site is not what will be built on the site.

    Beaverton Traffic Management Plan

    Hemstreet Heights neighbors asked about the packet they received in early February from the City of Beaverton traffic engineer. It included a survey about installation of four speed cushions using markups of AKS Engineering drawings with responses due by February 11. AKS was not aware of the proposed plan or the preparation of the packet.

    The information in the packet did not follow the Raleigh Crest Land Use decision, which required that Beaverton coordinate with neighbors according to Beaverton’s Neighborhood Traffic Calming Program. The Program calls for meetings with the neighbors and a 21-day response timeline, not 14 as provided. Approval of the Traffic Management Plan is required before the Stage 2 plat is recorded, which will be several months out. Construction of the new Dover Terrace will be part of Stage 2.

    Neighbors are following up with the City of Beaverton to schedule the required meetings. There are concerns about the location of the speed cushions, lack of bike lane striping on SW Dover St. for the Red Electric Trail, and other safety options that should be considered.

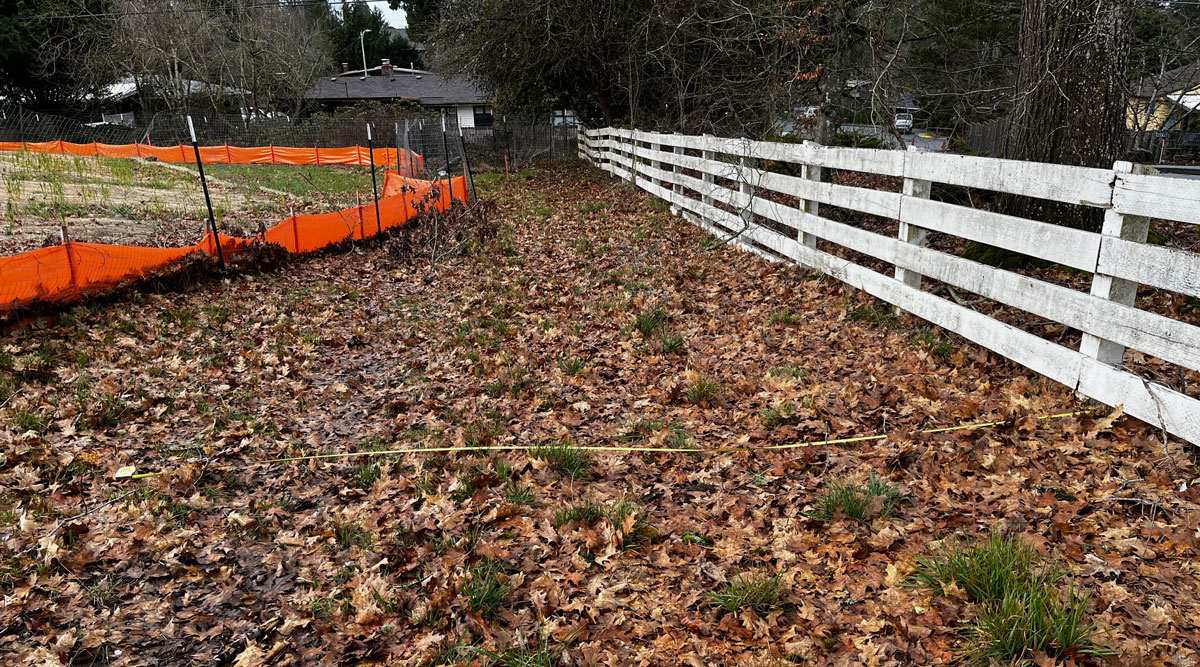

    Red Electric Trail

    Neighbors asked why the western trail access at SW Dover St. was moved from where it was initially proposed, which followed the long established walking path on the south side of the fence. The City of Portland said that installing the 12-foot wide trail there would impact the roots of the large trees along Dover St. so access was moved to the east. If the city should approve changing it back, it would require new permits which could likely cause a delay. AKS will install whatever the city requires.

    Get more history and updates about the Alpenrose site at Friends of Alpenrose.
